How do you spec Landfill racking without late cost surprises? Compare configurations, code requirements and quality checkpoints to de-risk the purchase.

Solar Racking on Landfill & Brownfield Sites

Closed landfills and contaminated brownfield land are the largest underused solar resource in most developed markets. They are close to load, already fenced, often already grid-connected, and unsuitable for almost any other use – which makes them cheap to lease and slow to permit.

The engineering constraint is that you cannot treat the ground normally. A landfill cap is a containment system, and breaching it is a regulatory offence rather than a construction problem. Contaminated ground carries similar restrictions on excavation and groundwater disturbance.

We supply non-penetrating and low-disturbance racking for capped and contaminated sites, with ballasted foundations, separation layers and above-ground cable routing designed around the site’s environmental controls.

Request a Project Quote

Why This Is Difficult

On a brownfield or landfill site the array design is downstream of an environmental constraint, and the constraint is not negotiable. Everything follows from what you are not allowed to disturb.

  • Landfill caps are engineered containment systems, and any penetration risks both the cap integrity and the site’s environmental permit
  • Settlement is expected and uneven, so foundations must tolerate differential movement without transferring load to the cap
  • Contaminated ground restricts excavation and can require groundwater protection measures that constrain both foundations and cable routes
  • Gas management infrastructure on landfill sites occupies surface area and imposes clearance and exclusion requirements
  • Cable routing must avoid creating preferential pathways for water or gas migration, which rules out conventional trenching
  • Permitting involves environmental regulators as well as planning authorities, and the schedule is driven by their review rather than by construction

Engineering Requirements

These are the design requirements that make a landfill or brownfield array permissible as well as buildable.

  • Assessment of the cap or containment system, with the design confirmed as non-penetrating before any foundation position is fixed
  • Ballasted or surface-mounted foundation design with a documented load-spreading layer and a stated maximum bearing pressure on the cap
  • Differential settlement tolerance designed into the structure, with adjustment provisions rather than a rigid frame
  • Cable routing designed with the environmental constraints, using above-ground ducts or channels that avoid creating migration pathways
  • Coordination with landfill gas infrastructure, including clearance requirements and exclusion zones around wells and flares
  • Environmental permitting documentation, including the construction method statement that the regulator will review

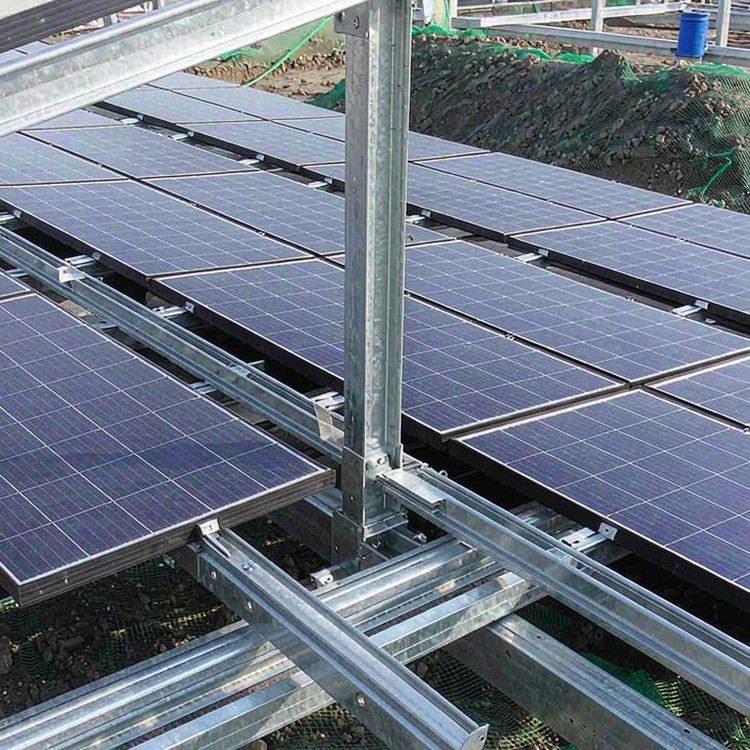

Solar Racking on Landfill & Brownfield Sites - installation detail

Selection guidance: confirm the containment constraints with the regulator before designing the foundation. On a capped site, the foundation design follows from the permit, not the other way round.

How We Solve It

  • Ballasted foundation systems with geotextile separation layers and load-spreading distribution, so no penetration occurs and bearing pressure stays within the cap’s allowance
  • Settlement-tolerant structure with adjustment provisions at the foundation interface, so differential movement is absorbed rather than resisted
  • Above-ground cable routing in ducted trays or channels, avoiding trenches that could create preferential pathways
  • Layout coordinated with gas wells, flares and monitoring points, maintaining all required clearances and access
  • Construction method statement prepared for environmental review, describing equipment, loading, and protection of the cap during installation
  • Reversibility designed in, so the array can be removed at the end of its life without disturbing the containment system

Beyond the Structure

  • Low-ground-pressure installation equipment specified in the method statement, protecting the cap during construction as well as operation
  • Monitoring provisions agreed with the operator, so cap performance can continue to be verified after the array is installed

Reference Benchmarks

Benchmarks below are publicly documented industry reference projects of comparable type and scale, cited to illustrate engineering practice. They are not our delivery record.

  • A 3 MW solar garden on a closed landfill in Italy, using ballasted foundations with a geotextile separation layer and above-ground cable routing.
  • Former military and industrial brownfield sites in Germany where cleared ground and low-disturbance foundations made reuse economically viable.
  • United States landfill-cap projects where environmental permitting, rather than construction, set the project schedule.

Standards and Compliance

  • ASCE 7 / EN 1991 wind loads resolved with site-specific terrain and exposure factors
  • IEC 61215 / IEC 61730 module interface compatibility verified against your module datasheet
  • EN 1090 or AISC execution classes for welded and bolted steelwork
  • Hot-dip galvanizing to ISO 1461, zinc mass specified by soil and atmospheric corrosivity
  • ISO 9001 production quality management with batch-level traceability
  • CE / EN 1090 documentation pack where destination markets require it

Quality Assurance

Every batch ships with mill certificates, coating-thickness logs and bolt records; welds follow EN 1090 or AISC execution classes. Structure warranty runs to 10 years against a 25-30 year service design life, and spare-part packages are documented so year-12 repairs do not depend on year-1 memory.

Documentation You Receive

Documentation is built for audits, not decoration: structural calculation notes stating load cases and standards used; foundation design basis mapped to your geotechnical report; material certificates for steel and fasteners; galvanizing certificates with measured coating thickness per batch; assembly drawings with torque tables; and packing documentation matched to container manifests. For financed projects we add lender-format compliance statements; for public tenders we respond to documentation schedules line by line.

Service Life and Maintenance Planning

Service life is a design output, not a promise. Zinc mass, fastener coating class, drainage detailing and dissimilar-metal isolation are selected against the corrosivity category of your site, and the expected first-maintenance interval is stated in writing. For aggressive environments we step the coating system up at design stage, which is always cheaper than a retrofit.

Cost and Commercial Considerations

  • Ballasted foundations typically add 30-60 percent over driven piles, driven by the load-spreading and separation design
  • Above-ground cable routing costs more than trenching and is usually unavoidable where excavation is restricted
  • Environmental permitting effort is substantial and largely fixed, making it proportionally heavy on smaller projects
  • Low-ground-pressure installation equipment raises construction cost but is usually a permit condition rather than a choice
  • Lead time: permitting typically governs, with fabrication and delivery able to proceed in parallel once the design is agreed

Frequently Asked Questions

Can you install solar on a capped landfill without breaching the cap?
Yes, using ballasted or surface-mounted foundations with a load-spreading layer and geotextile separation. The critical design outputs are the maximum bearing pressure on the cap and the distribution method. Nothing penetrates the containment system, and cable routing goes above ground in ducted trays rather than in trenches.
What about settlement?
It has to be designed for rather than avoided. Landfill caps settle unevenly, so the structure needs adjustment provisions at the foundation interface and enough flexibility to follow movement without concentrating load. A rigid frame designed for uniform support would fail; a structure with defined adjustment points can be re-levelled as settlement occurs.
How does permitting work on these sites?
It involves environmental regulators as well as planning authorities, because the site operates under a permit covering containment, gas and groundwater. The deliverables are typically a construction method statement, a foundation design demonstrating no breach of containment, and agreement on cable routing. In practice the regulatory review sets the schedule rather than construction.
Does solar interfere with landfill gas management?
It can if layout and clearance are not coordinated. Gas wells, flares, monitoring points and collection pipework all need access and defined clearances, and the array has to be planned around them rather than over them. We obtain the gas infrastructure layout during design and treat those elements as fixed obstacles.
What happens to the array at the end of its life?
It should come off without disturbing the cap. We design for component-level disassembly with recoverable ballast and above-ground cable containment, and we document the removal sequence. That keeps end-of-life cost predictable and preserves the site’s containment obligations.
